Antony Waste Reports 5.4% Tonnage Growth and Refinances Debt at Lower Cost in Q1 FY27

NSE

AWHCL

BSE

543254

  • Antony Waste Handling Cell Limited reported a steady Q1 FY27, with managed tonnage rising 5.4% YoY to 1.40 million tonnes and core revenue increasing around 7%. The company also reduced financing costs by refinancing a subsidiary loan, lowering the interest rate by 200 basis points.
  • Alongside the quarterly update, management provided an update on the July 8, 2026 force majeure incident at the PCMC Waste-to-Energy facility caused by exceptionally heavy monsoon rainfall.
PRICE-SENSITIVE TRIGGER

Event: Q1 FY27 Business Update

Type: Quarterly Operational Update

Impact: Moderately Positive

Immediate Effect: Healthy operational growth and reduced borrowing costs strengthen long-term profitability, although restoration of the PCMC Waste-to-Energy facility remains an important operational challenge.

Metrics:

Key Metrics:

  • Total tonnage managed: ~1.40 million tonnes (+5.4% YoY)
  • Collection & Transportation (C&T): ~0.55 million tonnes (+5.1% YoY)
  • Processing volume: ~0.85 million tonnes (+5.5% YoY)
  • Core revenue growth: ~7% YoY
  • RDF sales: ~40,000 tonnes (~28% YoY decline)
  • Compost sales: ~6,000 tonnes (Broadly stable)

Highlight:

  • Operational throughput continued to improve during the quarter, supported by growth in both collection and processing activities. While RDF sales declined due to the completion of the CIDCO biomining project, stable compost sales and higher waste handling volumes indicate resilient core operations. The refinancing is expected to strengthen free cash generation by reducing finance costs.
What Happened ?

Antony Waste Handling Cell delivered steady operational performance during Q1 FY27, supported by higher waste collection, transportation and processing volumes across existing contracts.

The company also refinanced the term loan of its subsidiary, Antony Lara Renewable Energy Private Limited, operating the Pimpri Chinchwad Waste-to-Energy facility, reducing its borrowing cost by 200 basis points.

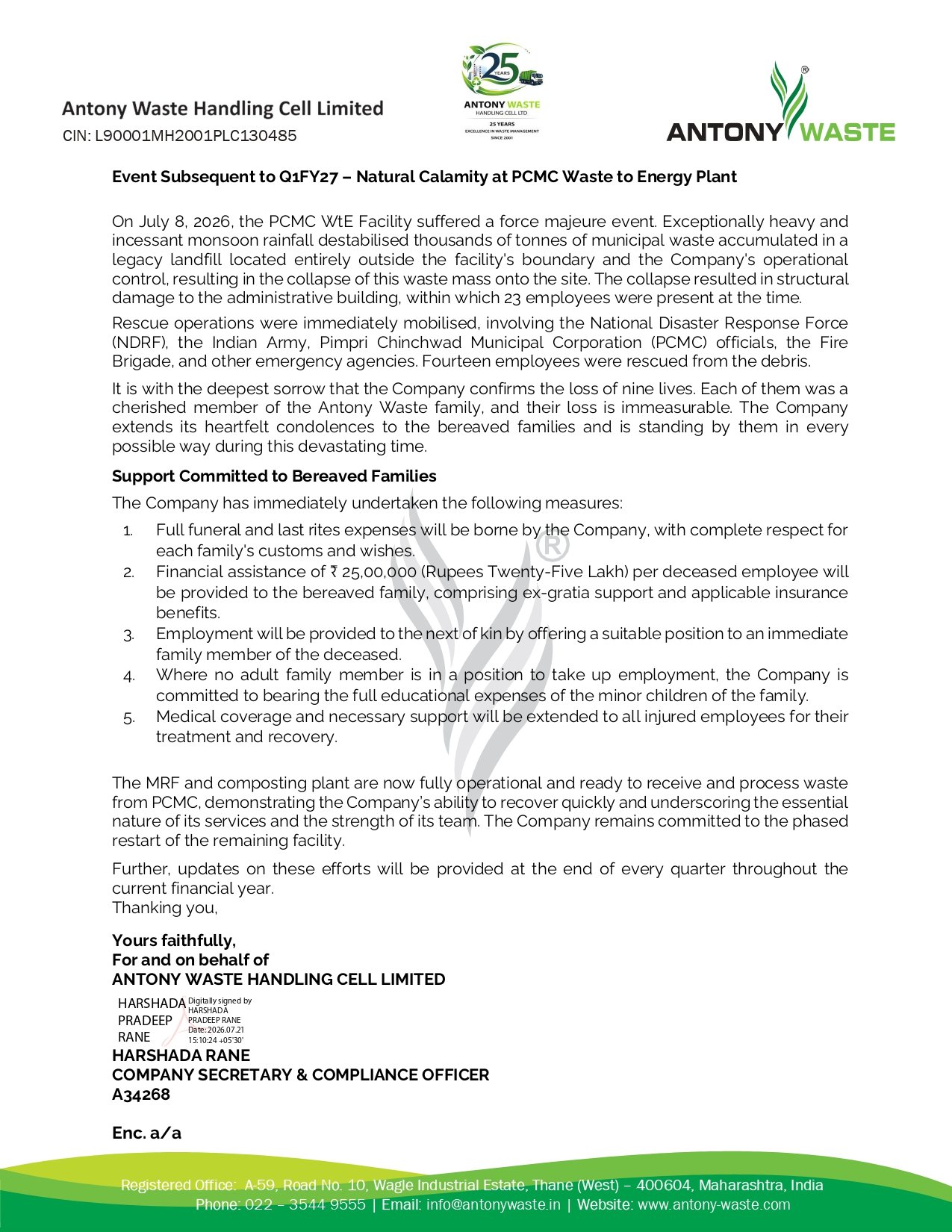

Subsequent to the reporting quarter, exceptionally heavy monsoon rainfall caused a collapse of accumulated legacy waste outside the PCMC Waste-to-Energy facility boundary, damaging the administrative building. The incident resulted in the loss of nine employees. Emergency rescue operations were conducted immediately with support from multiple government agencies.

key details

Operational Performance & Business Developments:

  • Total managed tonnage increased approximately 5.4% YoY to around 1.40 million tonnes.
  • Collection & Transportation volumes grew approximately 5.1% YoY.
  • Processing activity increased approximately 5.5% YoY.
  • Core revenue recorded around 7% growth, reflecting continued demand and improved operational efficiency.
  • RDF sales declined as the comparable quarter last year benefited from the now-completed CIDCO biomining project.
  • Compost sales remained broadly stable.

Capital Structure Improvement:

  • Subsidiary term loan refinanced from 10.25% to 8.25%.
  • Interest cost reduced by 200 basis points.
  • Expected benefits include:
    • Lower financing costs.
    • Improved subsidiary free cash flow.
    • Better long-term returns from the Waste-to-Energy asset.
    • More efficient capital structure.

PCMC Waste-to-Energy Facility Update:

  • A force majeure event occurred on 8 July 2026 following exceptionally heavy monsoon rainfall.
  • Waste accumulated in a legacy landfill outside the company’s operational control collapsed onto the facility.
  • Administrative building suffered structural damage.
  • Rescue operations involved NDRF, Indian Army, Fire Brigade and local authorities.
  • The Material Recovery Facility (MRF) and composting plant have resumed operations.
  • The company is continuing the phased restoration of the remaining facility.
Risk Analysis

Summary:

  • While operational performance remained healthy during Q1 FY27, the natural calamity at the PCMC Waste-to-Energy facility introduces operational disruption and execution risks until full restoration is completed.

Key Risks:

  • Restoration timeline for the remaining Waste-to-Energy facility.
  • Temporary operational disruptions following the force majeure event.
  • Potential financial impact from repair and restoration activities.
  • Lower RDF sales compared with the previous year’s high base.
  • Continued dependence on efficient project execution across municipal contracts.

Worst Case:

  • Prolonged restoration delays at the PCMC facility could temporarily affect processing capacity, operating efficiency and project economics.

Risk Level: Medium

Company Commentary
  • The company expressed deep condolences following the loss of nine employees.
  • Funeral and last rites expenses will be fully borne by the company.
  • Financial assistance of ₹25 lakh per deceased employee’s family will be provided, including ex-gratia support and applicable insurance benefits.
  • Employment opportunities will be offered to eligible immediate family members.
  • Educational expenses for minor children will be supported where required.
  • Medical treatment and recovery support will continue for injured employees.
  • The company remains committed to restoring full operations through a phased restart of the facility.
  • Further progress updates will be shared at the end of each quarter during the financial year.

Official Exchange Filing: Antony Waste Handling Cell Limited
